£75m
January 2015 – Ongoing
Location & Overview
Site preparation, remediation and infrastructure of 10 hectares of former industrial land, including former gas works, printing and dye works.
John F Hunt Regeneration undertook the role of Principal Contractor on the £75 million regeneration project in Stratford, London. The site had previously accommodated heavy industrial usage, their legacy comprising underground storage tanks, pipelines, ducts, pits and soakaways in addition to a residual process plant associated with a former oil terminal, printing ink and tar works. Significant pollution issues were present, including dense non-aqueous phase liquids in the form of coal tar in soils, heavy and light hydrocarbons, solvents and creosote in the underlying gravels. The scope of works encompassed the following:
Scope of Work
• Principal Contractor role • Demolition
• Removal of illegally deposited asbestos
• Remediation
• Ecology
• Infrastructure and highways
• Substantial drainage works
• Sheet piling – permanent & temporary
• River wall design & build
• Stabilised pile mats
• Reinforced earth retaining walls & structures
• Service installation & diversions
• Traffic management
• Materials modelling for construction phase
• Extensive use of BIM

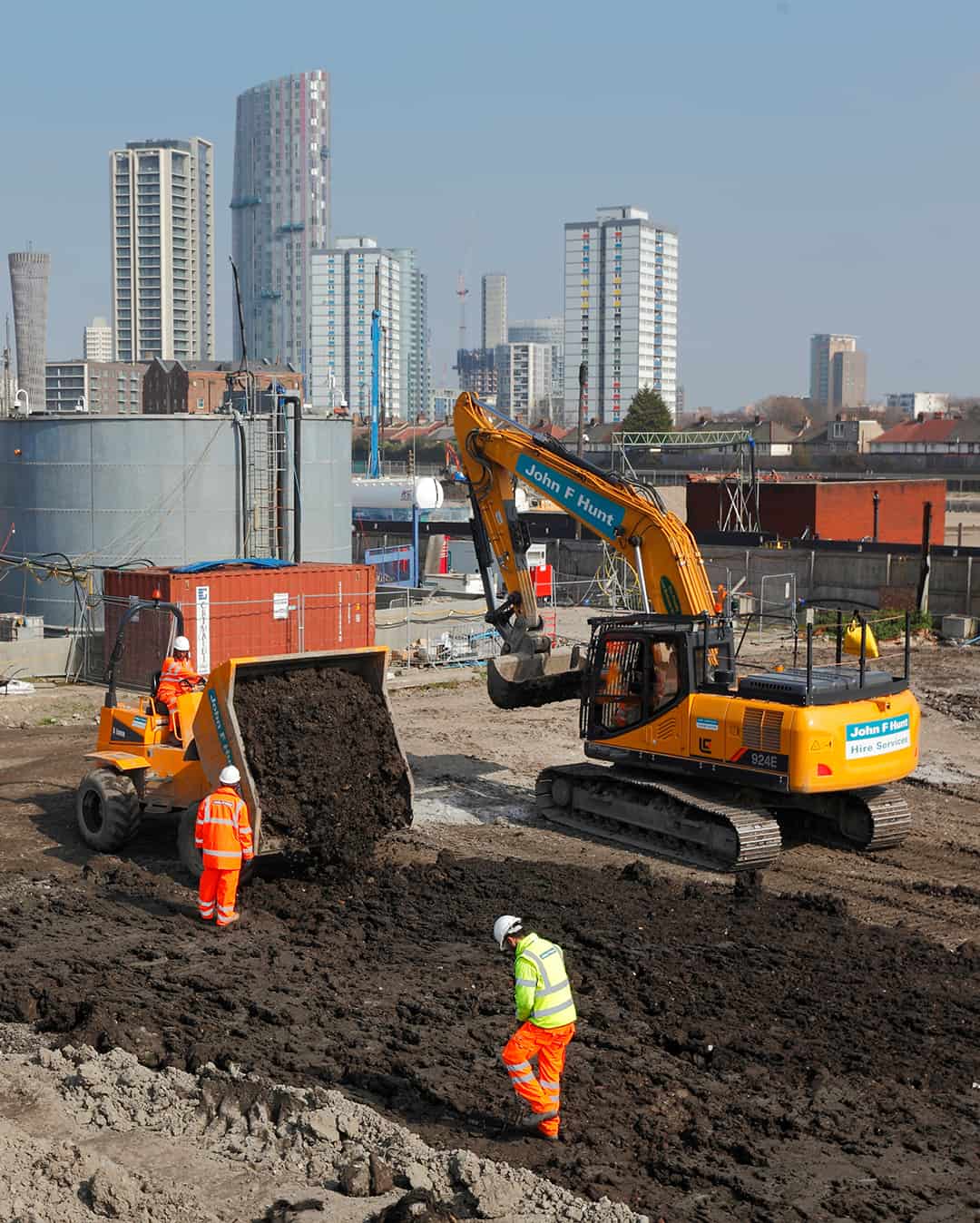

Remediation Work
Remediation was required to be undertaken in accordance with a strict construction programme, designed to allow the phased completion of development areas.
Installation of a steam injection system to reduce the viscosity of creosote contamination enabled the pollutant to be extracted from the underlying groundwater, whilst ensuring regulatory compliance.
Geotechnically stabilised materials were re-used in the highways works and as part of the pile mat construction, significantly reducing the requirement for imported recycled aggregates.
Treated materials meeting stringent remedial targets were placed within service corridors. Solvent, hydrocarbons and PAH contamination was treated on-site using a combination of complex sorting, advanced bio-remediation and windrowing techniques. The petroleum hydrocarbon impacted soils were then re-used to fill deep excavations once verified.
To satisfy planning conditions, site wide remediation and verification under the current Part IIA framework was required, as was the Ecological protection works for Japanese Knotweed and Giant Hogweed.
Challenges & Solutions
A greater volume of asbestos was discovered within the made ground than was indicated in initial site investigations. As a result, the original strategy would have required the removal of 30,000m3 of asbestos impacted soils from site to a licensed landfill and importation of material to compensate. The JFH team had to find solutions to mitigate the potential risk, with materials re-used in a safe and sustainable manner on site, with full regulatory approval. As a result the Remedial Design was adapted to include revised re-use criteria for asbestos within soils.
Implementing all relevant health, safety and statutory requirements, impacted soils were excavated under controlled conditions under an ASB5 Notification to the HSE. Soils were then treated on site and verified for re-use at depth below a capping layer, in full accordance with the updated design.
The masterplan altered the levels dramatically across the site by approximately 4 meters. Innovative solutions were required with regards to materials management to address the change in levels and earthworks balance.
To overcome the shortfall in recycled aggregates, the Remedial Design was adapted to allow the stabilisation and re-use of geotechnically poor materials. The team were able to identify re-use locations for each material type through the innovative use of BIM
Extensive stakeholder and community engagement measures were necessary, with working practices and methodologies adapted due to our proximity to site neighbours, thus minimising the potential risk to human health and ensuring the protection of the adjacent controlled waters.
Added Value
Our Considerate Constructors Scheme score for the site is an exceptional 44/50 with an innovation score for the project of 8.2.
Due to complex ground conditions and challenging engineering requirements, we implemented the following innovative solutions:
Remedial adaptions regarding asbestos in soils negated the need to remove 30,000m3 of impacted soils to landfill.
2,159 tonnes of CO2 were saved by retaining geotechnically poor material on site and importing aggregates to replace the shortfall 50,000m3 of material was treated using advanced bioremediation techniques for re-use in accordance with the remedial strategy. We saved approximately 5,300 unnecessary lorry movements and 1,000 tonnes of CO2.
The use of BIM enabled the continuous real-time management and placement of the soils, alongside continual stockpile management and tracking to ensure regulatory compliance for re-use of treated soils, including asbestos treatment. This approach ensured that swift regulatory approval was gained to enable prompt commencement of the construction phase.
Award-winning: We successfully delivered the project and the scheme won the Best Biodiversity Enhancement Award at the flagship Brownfield Briefing Awards in 2017
We saved our client millions of £’s by adapting the remedial strategy regarding asbestos contamination, negating the removal of 30,000m3 of impacted soils to landfill
By not needing to remove the geotechnically poor material from site and import aggregates to replace the shortfall, 5,300 unnecessary lorry movements and 2,159 tonnes of CO2 were saved
7,000 litres neat creosote was removed from the groundwater and approx. 50,000 m3 of soil was treated using sustainable techniques – making the project one of the largest remediation schemes in the UK
